The 42-Day Benchmark: Beston’s Oil Sludge Recovery Project in Africa

On April 12, 2026, Beston Group successfully completed the installation and commissioning of a BLJ-16 TDU project in Africa. Executed in just 42 days, this record-breaking deployment transforms hazardous oilfield waste into valuable industrial fuel, empowering the client to achieve rapid operational readiness and capture sustainable revenue from resource recovery.

On-site View of Thermal Desorption Unit Project in Africa
On-site view of thermal desorption unit project in Africa (Credit: Beston Group)

Strategic Partnership: Local Resource Recovery & Dual-Revenue Business Model

In this project, the client operates in close collaboration with local oilfields in Africa, taking direct responsibility for the management and processing of oil sludge generated during extraction and production activities.

Objective 1: Capturing Waste Treatment Service Fees

The client generates immediate cash flow by providing professional, compliant disposal services for hazardous oil sludge, helping oilfields meet environmental requirements while securing a steady service-based income.

Objective 2: Maximizing Profit from Pyrolysis Oil Sales

Beyond simple disposal, the project focuses on resource recovery. The high-quality pyrolysis oil extracted from the sludge is sold as industrial fuel, allowing the client to capture significant market value from what was previously considered waste.

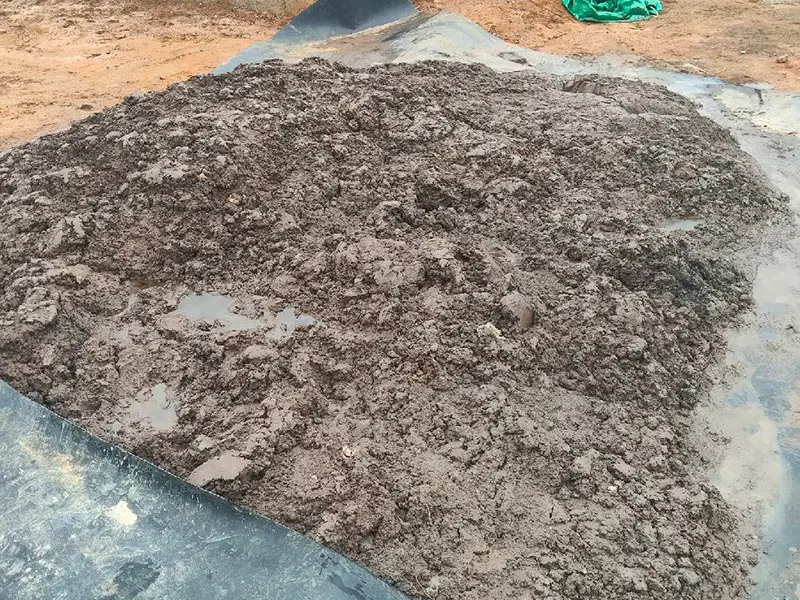

Landing Oil Sludge and Oil-based Drill Cuttings
Material: landing oil sludge and oil-based mud

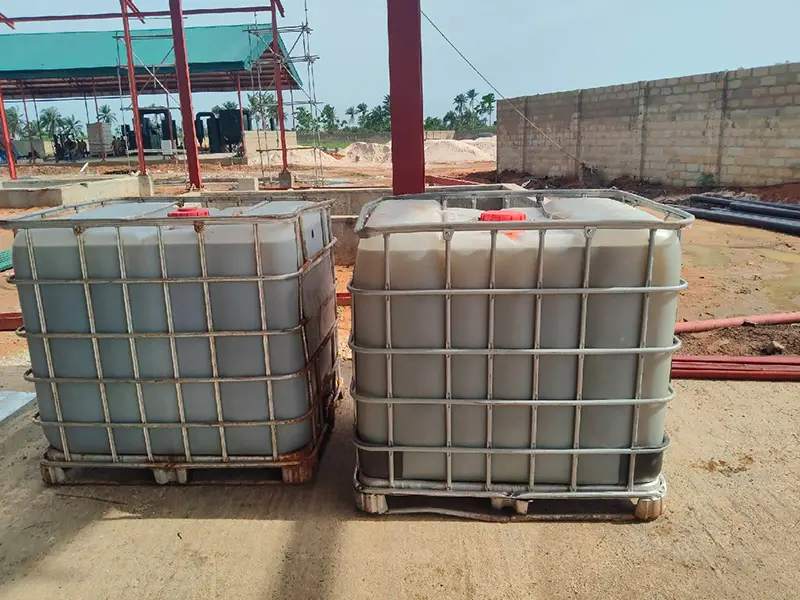

Pyrolysis Oil Produced During Trial Runs
Pyrolysis Oil Produced During Trial Runs

Record-Breaking Efficiency: 42-Day Rapid Installation and Commissioning

In response to the client’s operational needs, Beston Group implemented a high-efficiency deployment strategy. By completing the entire process from arrival to final commissioning in just 42 days, our technical team set a new internal speed record, allowing the client to transition toward production far ahead of schedule:

Project Information

  • Equipment model: BLJ-16 Thermal Desorption Unit (TDU)
  • Key components: Corrosion-resistant 304 stainless steel reactor and a high-efficiency screw feeder system
  • Processing material: A mix of landing oil sludge and oil-based drill cuttings (OBM)

Project Key Timeline

  • Installation period: March 2 – March 31, 2026
  • Commissioning period: April 1 – April 10, 2026
  • Project completion & acceptance period: April 11 – April 12, 2026
  • Total duration: 42 Days (Setting a new benchmark for project delivery)

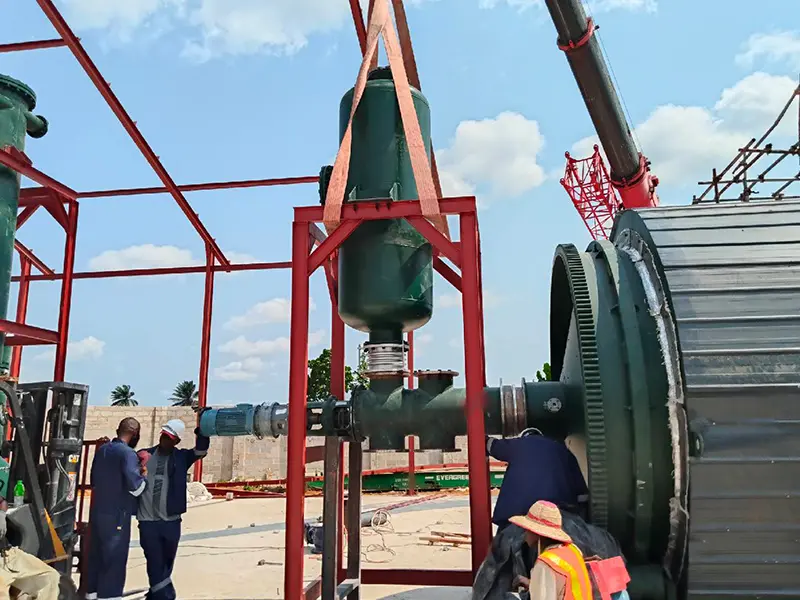

Installation Site of the Oil Sludge Pyrolysis Project

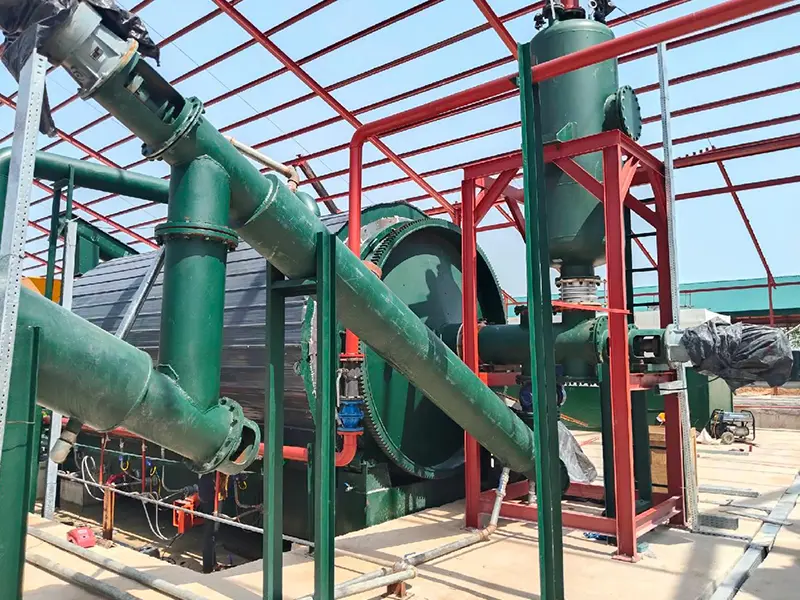

Africa BLJ-16 Oil Sludge Pyrolysis Project

From Challenge to Solution: Technical Refinement & System Stabilization

Despite the tight 42-day schedule, Beston Group’s technical team provided rapid, high-precision support to overcome complex on-site challenges. By proactively identifying and resolving technical hurdles, we ensured the system achieved peak operational stability and safety:

NO.1
NO.2
NO.3
Signal Interference Optimization

Signal Interference Optimization

  • Issue: Thermocouple temperature readings fluctuated abnormally in correlation with the VFD (Variable Frequency Drive) frequency.
  • Solution: Identified as a control signal cable interference; resolved by reconfiguring PLC communication wiring and optimizing the electrical cabinet layout.
Mechanical Precision Adjustment

Mechanical Precision Adjustment

  • Issue: High pump noise and damage to the flexible coupling.
  • Solution: Re-aligned the concentricity between the motor and the pump, replacing the coupling to ensure smooth long-term operation.
Electrical Safety Rectification

Electrical Safety Rectification

  • Issue: Incorrect grounding of the VFD and missing ground wires in the cabinet.
  • Solution: Standardized all grounding connections to ensure equipment safety and prevent electronic damage.

Project Conclusion: Ready for Full-Scale Operation

The installation and commissioning of the BLJ-16 oil sludge pyrolysis plant have been successfully completed, marking the transition to the pre-production phase. As the client currently moves forward with obtaining relevant operational certifications, the project is strategically positioned to realize its commercial objectives.

Complete Installation and Commissioning of BLJ-16 in Africa
Complete Installation and Commissioning of BLJ-16 in Africa (Date: April, 2026)
